How long does a rebrand take, and what actually sets the pace

See what sets a rebrand timeline: research, identity work, approvals, website changes and rollout dependencies. Compare scope before comparing weeks.

Read article Use framework
Share this guide

Send it to someone working through the same question.

In short, Customer experienceCompare the proposed work and its dependencies before comparing the number of weeks.Branding Tatva · Insights
A thought to take into the work.

Start here

The direct answer

A rebrand has a project specific timetable. Research already available, the identity materials to create, review arrangements, website changes and rollout dependencies all belong in the estimate. Ask for dated stages, deliverables, review time and the assumptions behind the launch date. A short quote can cover a focused change or reuse settled work; a longer quote can include substantial implementation. The number of weeks alone tells you little about the quality or completeness of the proposed work.

Link to the direct answer

Key takeaways

What to take from this article.

  • Compare the proposed work and its dependencies before comparing the number of weeks.
  • Research, identity development, review and rollout can overlap or require earlier decisions. Ask the provider to explain that sequence.
  • Review arrangements affect timing through availability, feedback and decision authority. Headcount alone cannot predict a delay.
  • Distinguish approval of the identity from completion of the website, documents and other launch materials.
  • A coordinated launch or a planned transition can both be suitable. Choose around customer understanding and the materials you can actually update.

Working framework · 5 decisions

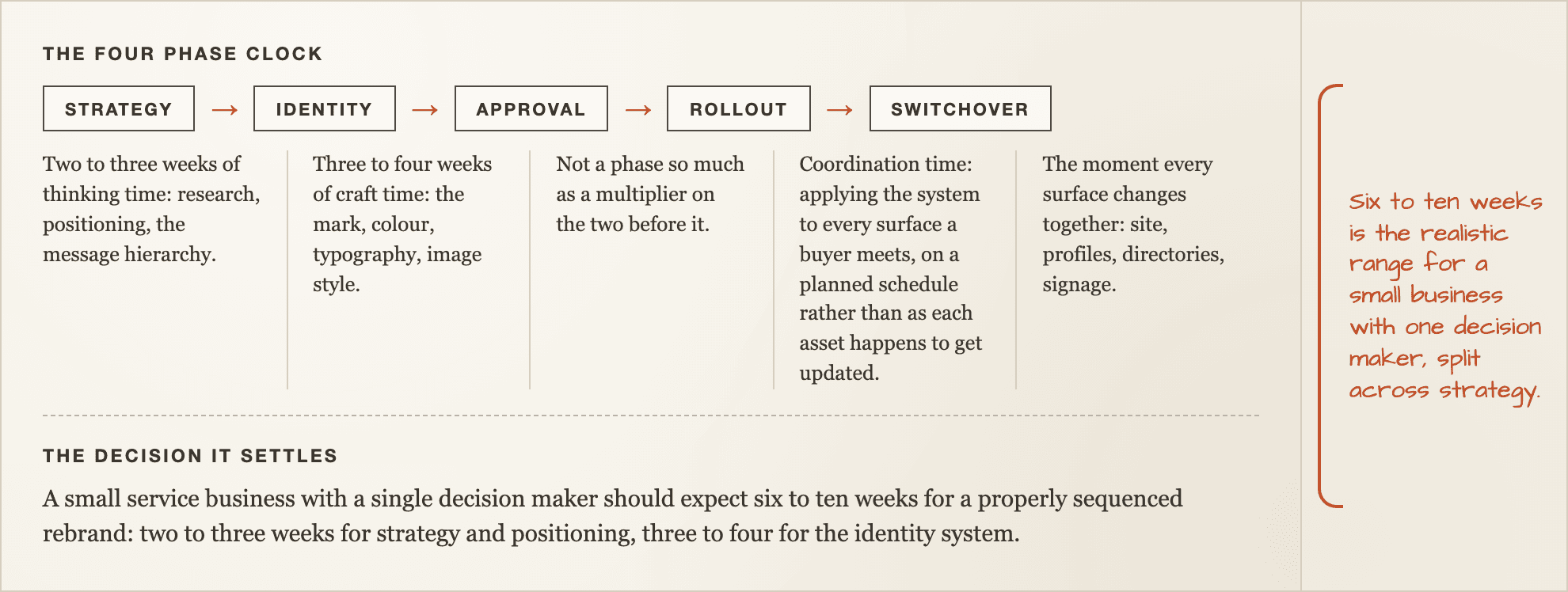

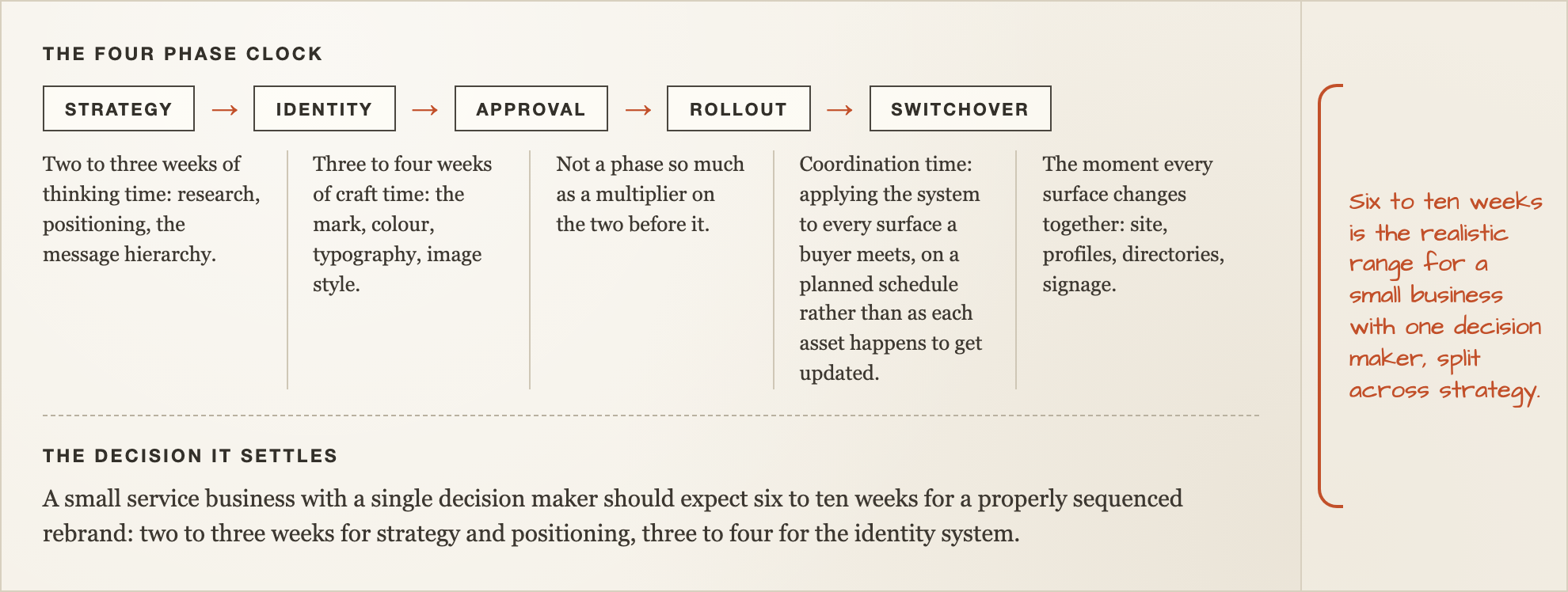

Five schedule checks

Use these five checks to discuss a proposal. They describe planning questions, rather than a fixed industry sequence or a promised delivery time.

Decision 01 / 05

Strategy

Identify existing research, the questions still open and the decisions the identity will need. Agree what evidence can be gathered within the brief.
Read all 5 decisions
  1. Strategy

    Identify existing research, the questions still open and the decisions the identity will need. Agree what evidence can be gathered within the brief.

  2. Identity

    List the design work and formats to deliver. Compare a logo adjustment with a wider identity system, templates and guidelines.

  3. Approval

    Name the decision owner, contributors, feedback deadlines and agreed review rounds. Explain how new information can change the plan.

  4. Rollout

    Include the people, suppliers and access needed to update the website, documents, listings and physical materials.

  5. Switchover

    Choose a coordinated launch or a planned transition. Explain how customers will recognise the business while materials change.

Start with the scope behind the estimate

A timeline is useful when you can see what it includes. Ask which customer questions need research, which positioning decisions are already settled, which identity materials will be created and who will apply them. A focused visual update and a wider change to the name, offer and website have different requirements.

Hypothetical planning example: a small consultancy could propose an eight week window, with the first two weeks for discovery and direction, the next three for identity development and review, and the final three for website and document preparation. That illustration assumes available research participants, a named approver, limited deliverables and booked implementation capacity. Change those assumptions and the estimate changes.

The example is a discussion aid rather than an industry benchmark, a recorded client result or a Branding Tatva delivery commitment. Ask a provider to build the estimate from your brief. A fast quote may reuse settled work; a longer one may include research, naming reviews, procurement or a substantial website.

Read the assumptions

Agree what will be ready, who must contribute and which dependencies can move the date.

Separate the work and explain its dependencies

Discovery needs access to relevant people and existing materials. Identity development needs enough direction to make and test options. Implementation needs approved files, technical access and people who can apply the system. Identify where work can overlap and where a decision must come first.

The Design Council describes design as an iterative process: early testing can change the understanding of the problem. That supports leaving room to learn and revise. The framework supplies process guidance; it establishes no universal number of weeks for branding.

A useful schedule includes outputs for each stage, the review points and the conditions for moving forward. Ask whether an identity approval means files are ready for handover or whether the website, templates and customer communications are also included.

Plan how reviews become decisions

Multiple contributors can bring knowledge that a founder alone lacks. Timing depends on how those contributions are organised: availability, conflicting requirements, decision authority and the way feedback is gathered. An extra person has no automatic cost in weeks.

Name who gathers feedback, who reviews specialist issues and who approves each output. Book review windows before work begins. A consolidated response can help the provider understand which changes are required and which comments express a preference.

Agree the included review rounds and how a changed brief will affect scope, timing and cost. Two rounds may suit one assignment while another needs more. Treat that agreement as a project decision, rather than a universal limit.

  • Record the final approver and the contributors for each deliverable.
  • Provide a feedback deadline and a single agreed response.
  • Explain how new requirements, unavailable reviewers and changed priorities affect the schedule.

Include the work after identity approval

List the materials customers will encounter: website pages, proposals, invoices, profiles, directories and physical items where relevant. Record the owner and lead time for each. Identity files arriving at handover can be only one milestone in that list.

A coordinated launch can reduce conflicting presentations. A planned transition can also be suitable where existing stock, supplier lead times, customer relationships or technical dependencies require it. Explain the connection between old and new materials and decide which updates need to happen together.

Check links, redirects where URLs change, readable templates and customer communications before launch. Keep a way to correct a failed update. These are practical planning suggestions; their effect on recognition or enquiries depends on the business and the execution.

Define launch readiness

Record which materials must be ready together, which can transition later and how customers will understand the connection.

Plan a startup rebrand around what must be ready at launch

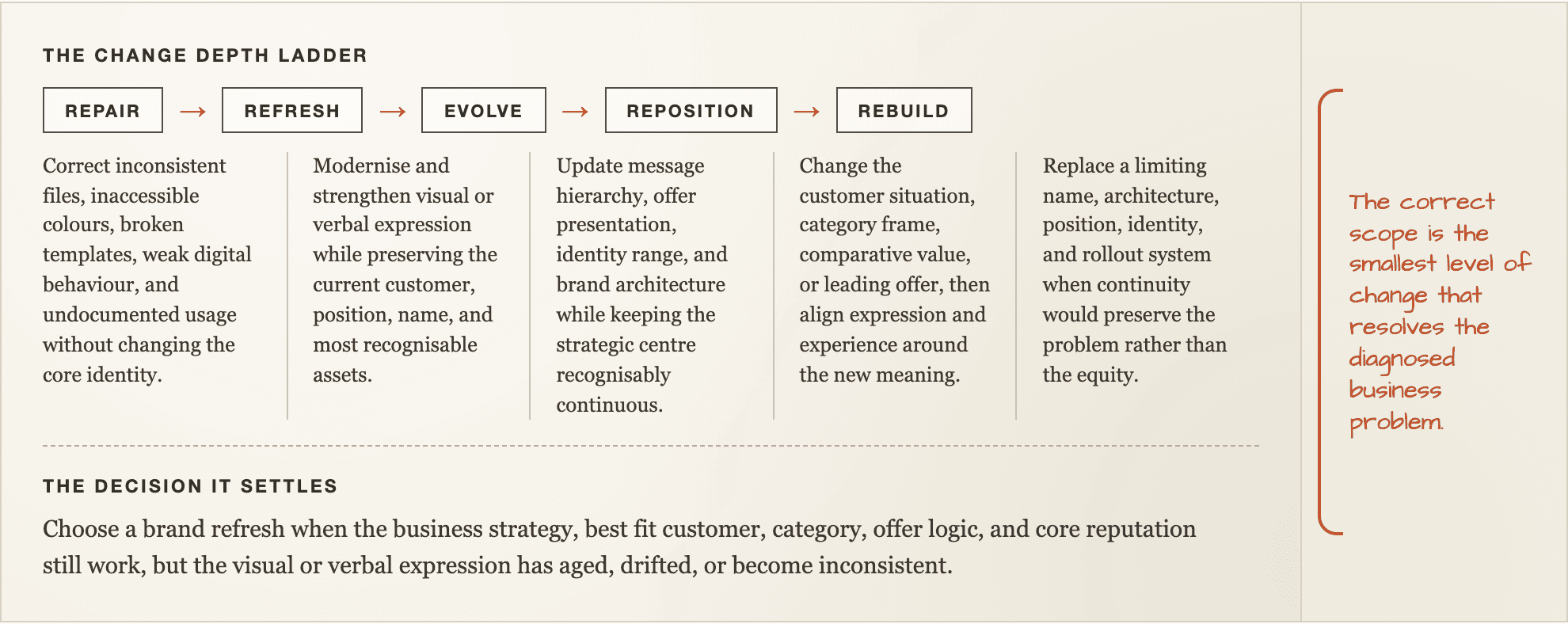

For a startup, begin with the decision already made and the work still open. A settled offer with an inconsistent identity needs a different plan from a business still changing its audience, name or service. Those decisions still matter when the website has only a few pages.

Create two lists: what customers need on launch day and what can follow without confusing them. Assign an owner, input deadline, review date and completion check to each item. This suggested planning worksheet sets out questions to resolve; the proposal defines the schedule and delivery commitments.

  • Settle first: the audience, offer, name and main message needed to write and design the launch materials.
  • Ready for launch: the agreed identity files, essential website pages, working enquiry or purchase route and customer announcement.
  • Can follow: additional articles, optional templates and later campaign assets, where the business can operate clearly without them.
  • Dependencies: record who supplies final copy, images, technical access and any specialist approvals required by the brief.
  • Decision point: if an essential item is late, agree a smaller launch scope or a revised date before publishing.

Read the proposal against the launch date

The Design Business Association recommends a proposal that explains the process, people, expected duration, cost and deliverables. Apply those questions to the date on the cover. Ask what the provider needs from you and what work your own team or suppliers must complete.

Distinguish a target date from a commitment with agreed assumptions. Ask what happens if research access, approvals or implementation materials arrive late. A useful answer identifies the dependency, the person responsible and the work that can continue.

Compare proposals using the same required outputs. Check research, identity files, templates, guidelines, implementation and transition responsibilities separately. Bring your launch date and existing materials to the conversation so the scope can be agreed before a delivery schedule is promised.

Before you use it

Questions that can change the recommendation.

How long does a startup rebrand take?

A startup rebrand needs an estimate built around its unresolved decisions and launch materials. Confirm the audience, offer and name first, then schedule identity, copy, website work and reviews. Separate launch essentials from later assets and name an owner for each dependency. A small team or short website cannot establish a fixed duration; ask for a dated plan and the assumptions that could move it.

Link to this answer
Can a rebrand be done faster than six weeks?

Yes, depending on the scope and the work already available. A focused update or an identity built from settled direction can have a shorter schedule. Ask which outputs, research, review and implementation are included and which assumptions support the date. A short timetable alone cannot establish that strategy has been skipped.

Link to this answer
Why do rebrands for larger companies take so much longer?

Larger programmes may involve more markets, services, technical systems, physical materials, suppliers or specialist reviews. Those dependencies can affect timing alongside approval arrangements. Request a schedule tied to the actual work instead of estimating delay from organisation size alone.

Link to this answer
Should the old brand and new brand ever run at the same time?

Yes, a planned transition can make sense when stock, supplier timing, customer communications or technical dependencies require it. Agree which materials change together, how customers will recognise the connection and who owns later updates. Define the transition using the actual constraints.

Link to this answer
Does a rebrand timeline include the strategy work, or just the design?

The proposal should state which decisions and outputs are included. Existing research and positioning may be usable; unresolved decisions may require more work. Check strategy, identity, review, handover and implementation separately so the launch date describes the work you actually need.

Link to this answer
What is the biggest cause of a rebrand running over schedule?

The main risk varies by project. Review delays, unavailable research participants, changed scope, supplier lead times and technical dependencies can each move a date. Record the assumptions, decision owners and response to a delay. Agree review rounds without treating one cause as a universal ranking.

Link to this answer

Research record

What this guide draws from.

Each source note describes what the reference supports. Platform guidance, research findings and Branding Tatva's practical suggestions have different scopes.

  1. Framework for Innovation (opens in a new tab)

    Design Council

    Supports discovery, testing and iteration. The five schedule checks and eight week illustration are original planning suggestions; the framework supplies no standard branding duration.

  2. How to buy design: Asking for a proposal document (opens in a new tab)

    Design Business Association

    Supports reviewing process, people, expected duration, cost and deliverables. The hypothetical schedule is an illustration, with no measured duration or fixed approval delay established by this guidance.
